Washington Parkway

Project Description:

We are excited to announce that construction has begun for the Washington Parkway Project.  This project will construct a two lane road extension of Washington Parkway from Exit 13 to Green Springs Drive.  This project will also include crossing Mill Creek Wash.  The Contractor will start at the wash crossing by preparing the ground to start building the crossing structure.  The Contractor is also bringing in material and equipment needed to construct the project.

01/21/2020

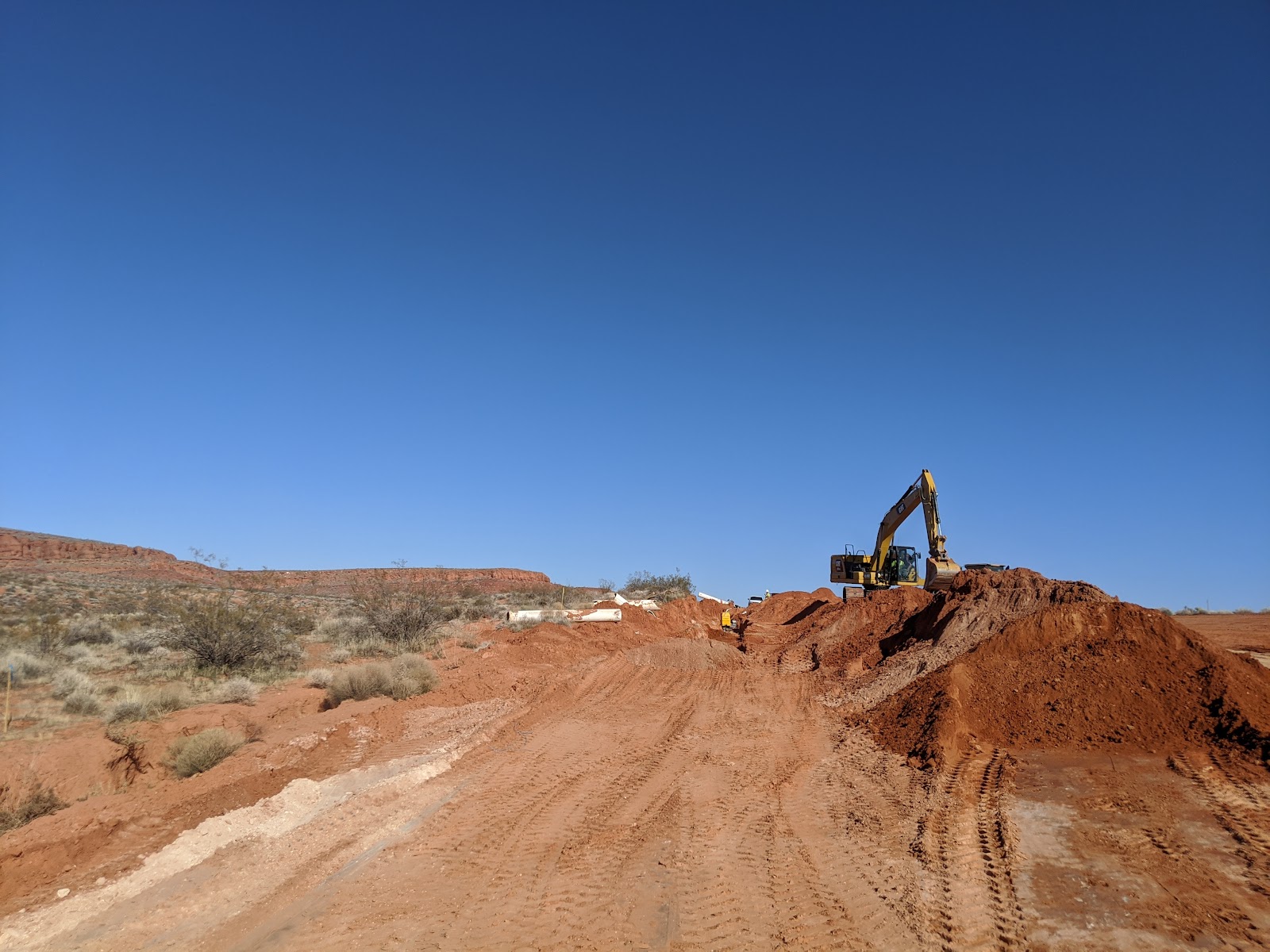

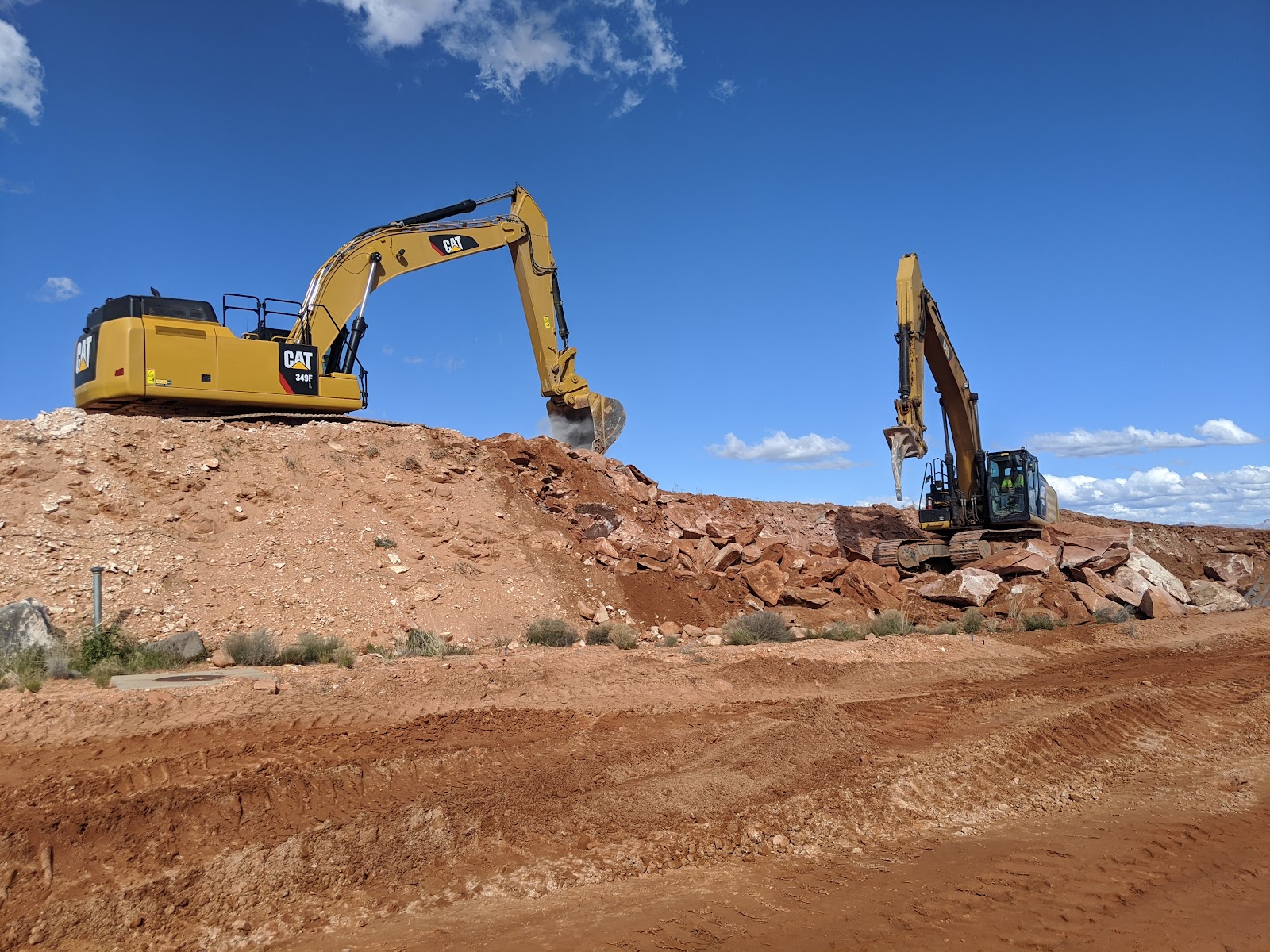

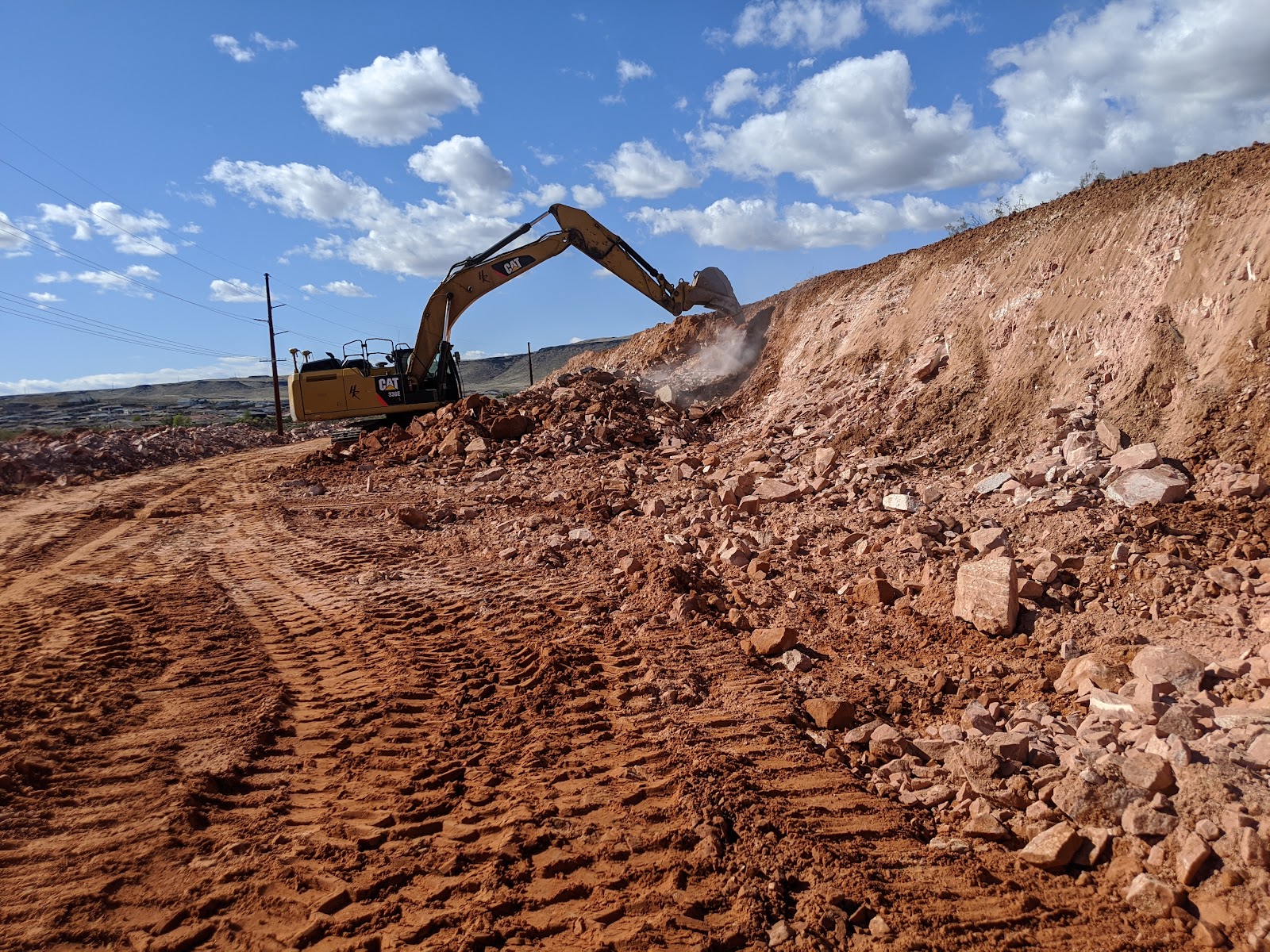

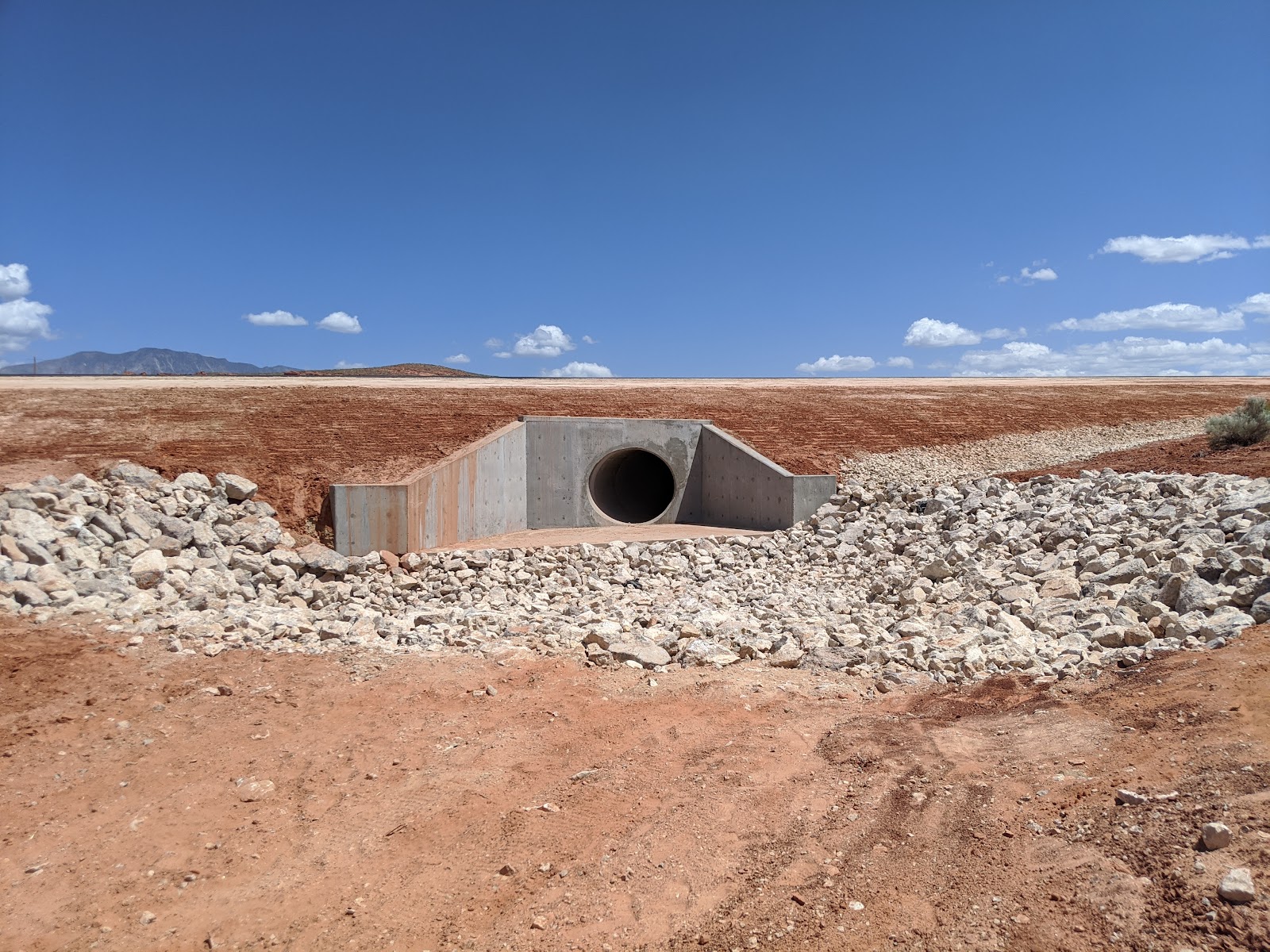

The Washington Parkway Project is fully underway.  The Contractor has the pad for the wash crossing box structure prepared and will be working on forming the footings next.  The Contractor is also working on installing storm drain pipes at various locations along the project.  One of the most noticeable changes on the project site is the dirt grading that the Contractor has started on.  They are moving the dirt with tractors.  These tractor are very large, take a long time to stop, and do not give the operator the best view of what is around them.  For your own safety please stay far away from the construction site and especially the large equipment.

1/28/2020

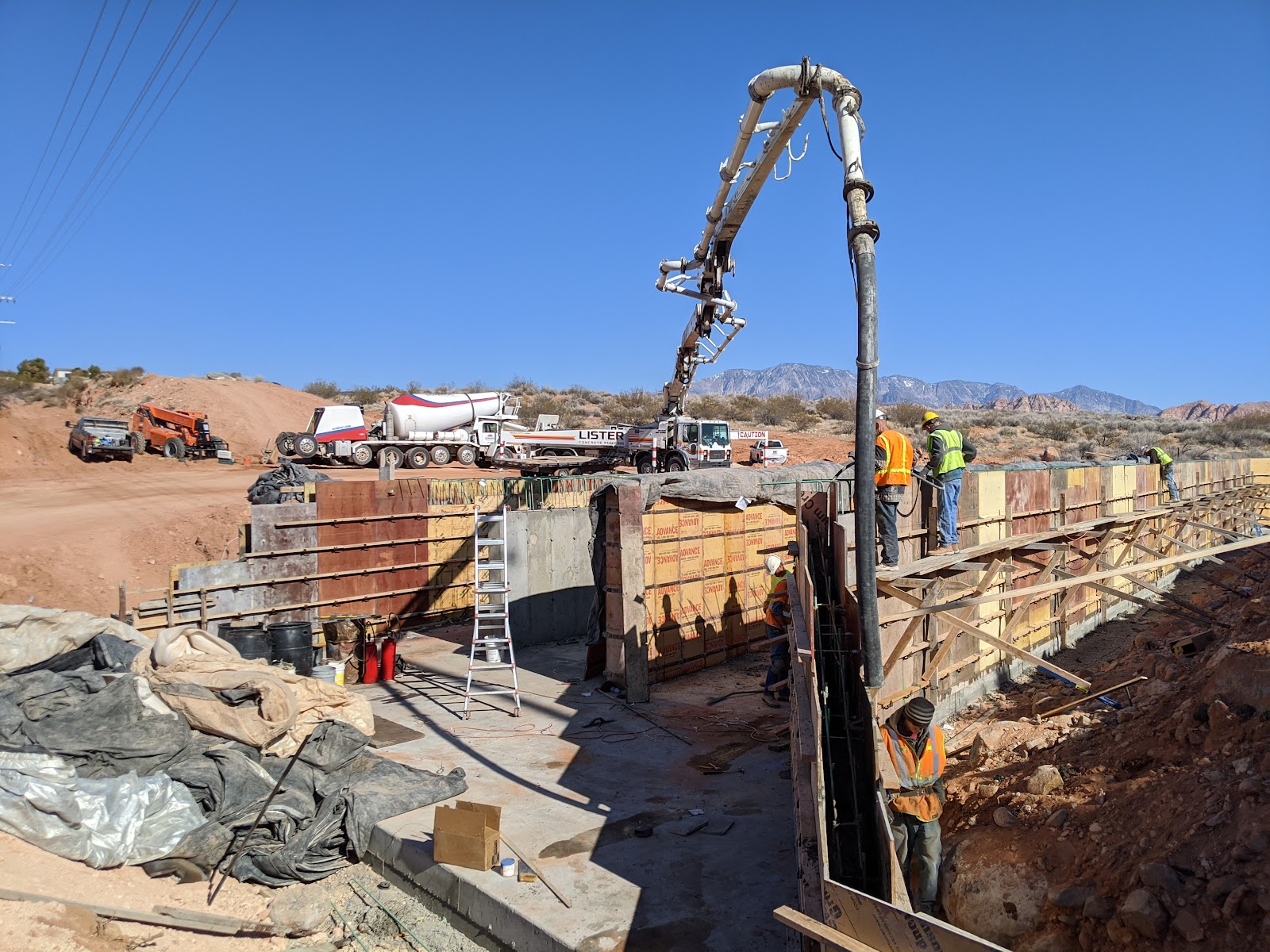

The Washington Parkway Project Contractor is continuing to work on the wash crossing box structure.  They have crews laying out rebar in preparation for pouring the floor.  The Contractor is also continuing to install storm drain pipes at various locations and along the project.  One of the storm drain pipe they will be starting to install this week is 72” tall.  In an effort to improve safety and inform the public the Contractor has prepared a flyer about the project.  It also give information about who they are and how to contact them.

2/24/2020

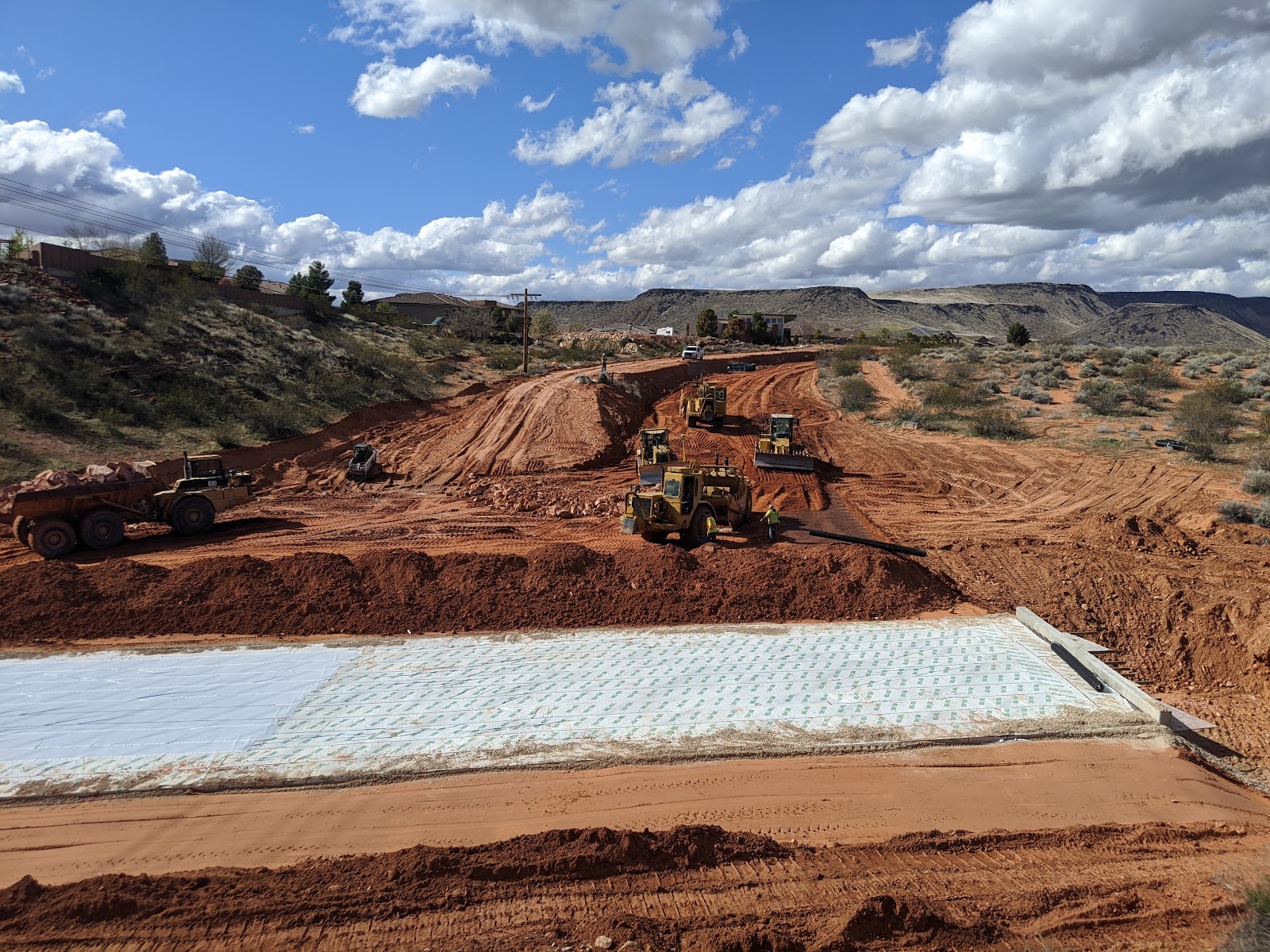

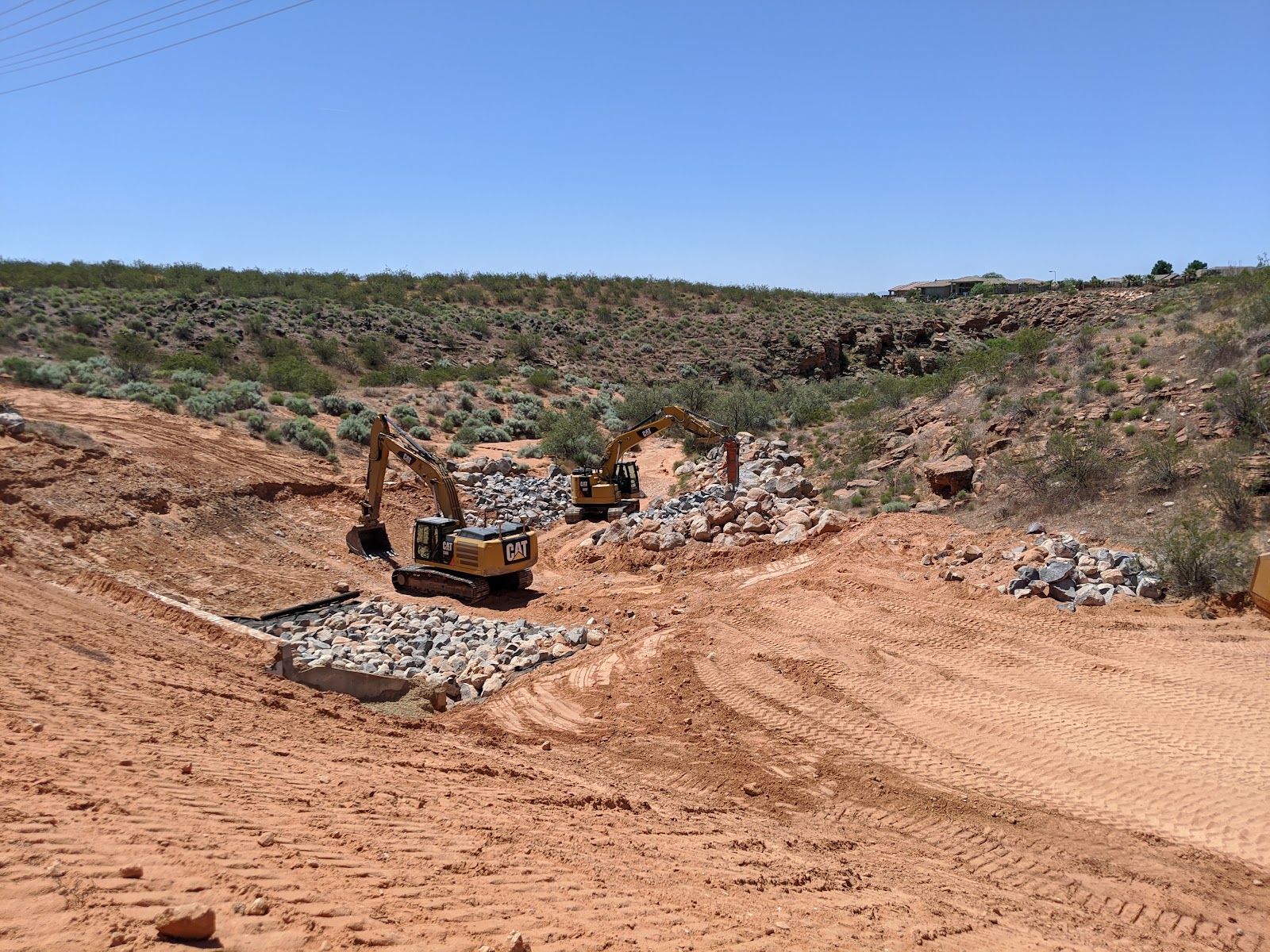

The Contractor has finished the first phase of dirt moving and storm drain pipe installation along the length of the project. They are now working on replacing sections of waterline that run the length of the project.  The Contractor has also finished pouring the floor and walls of the concrete box structure crossing the Mill Creek wash. They will continue preparing rebar and forms and should be pouring the final concrete on the top of the structure in the coming weeks.  Once the box structure crossing Mill Creek has been completed, the Contractor will start work on final dirt moving, waterline installation, and storm drain pipe installation for the final section of the road in the area of the box structure.



Update 3/9/2020

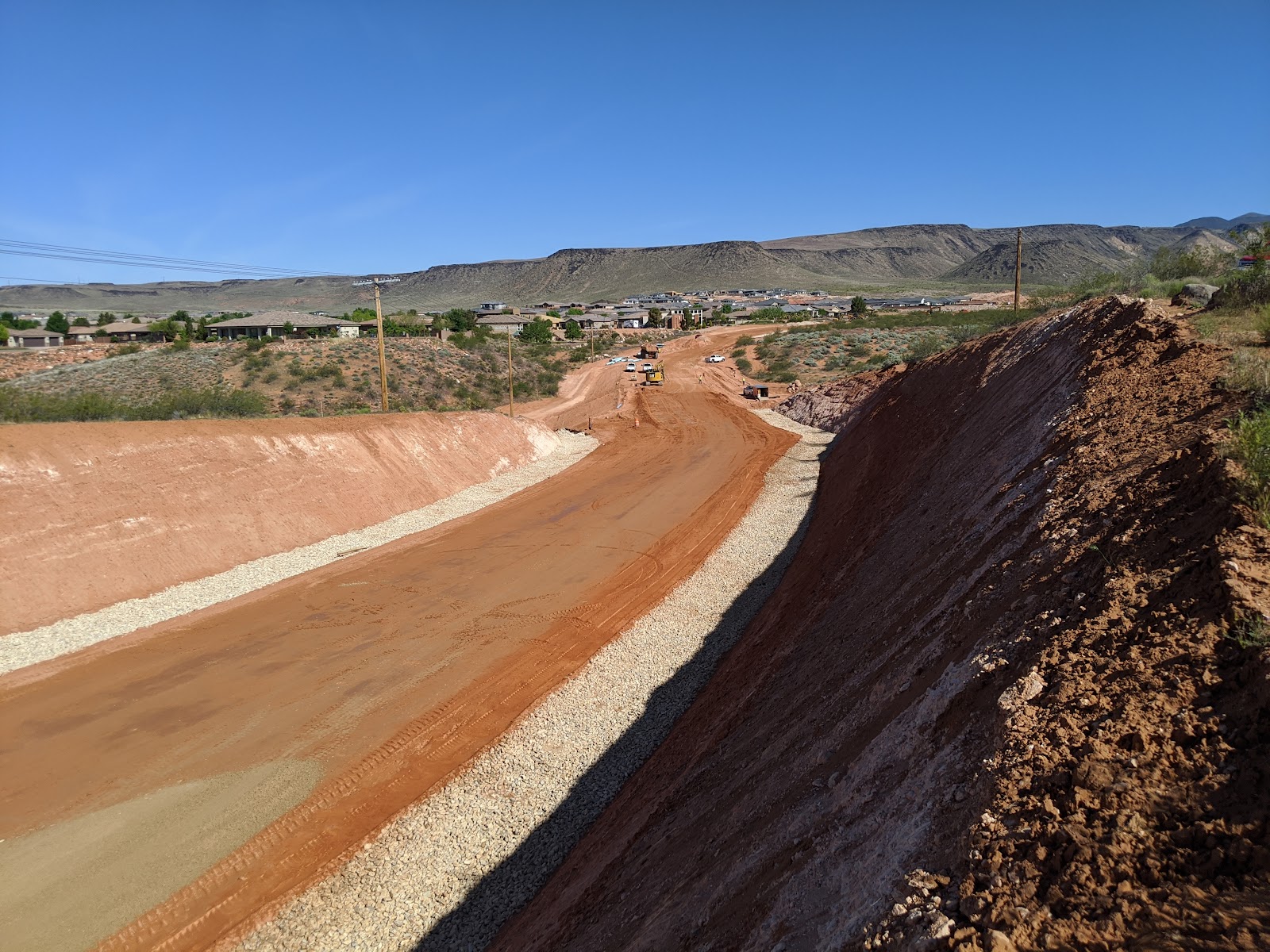

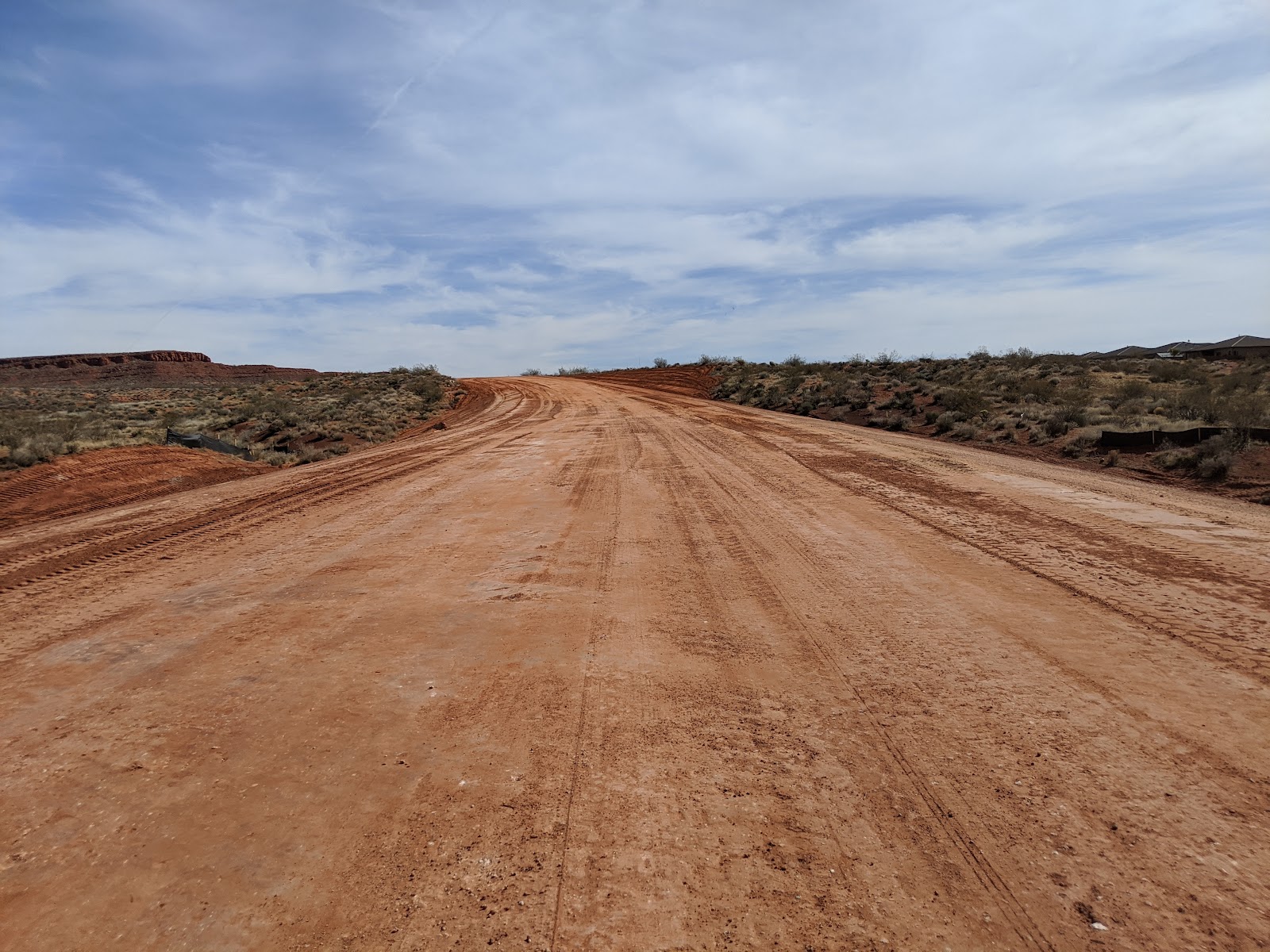

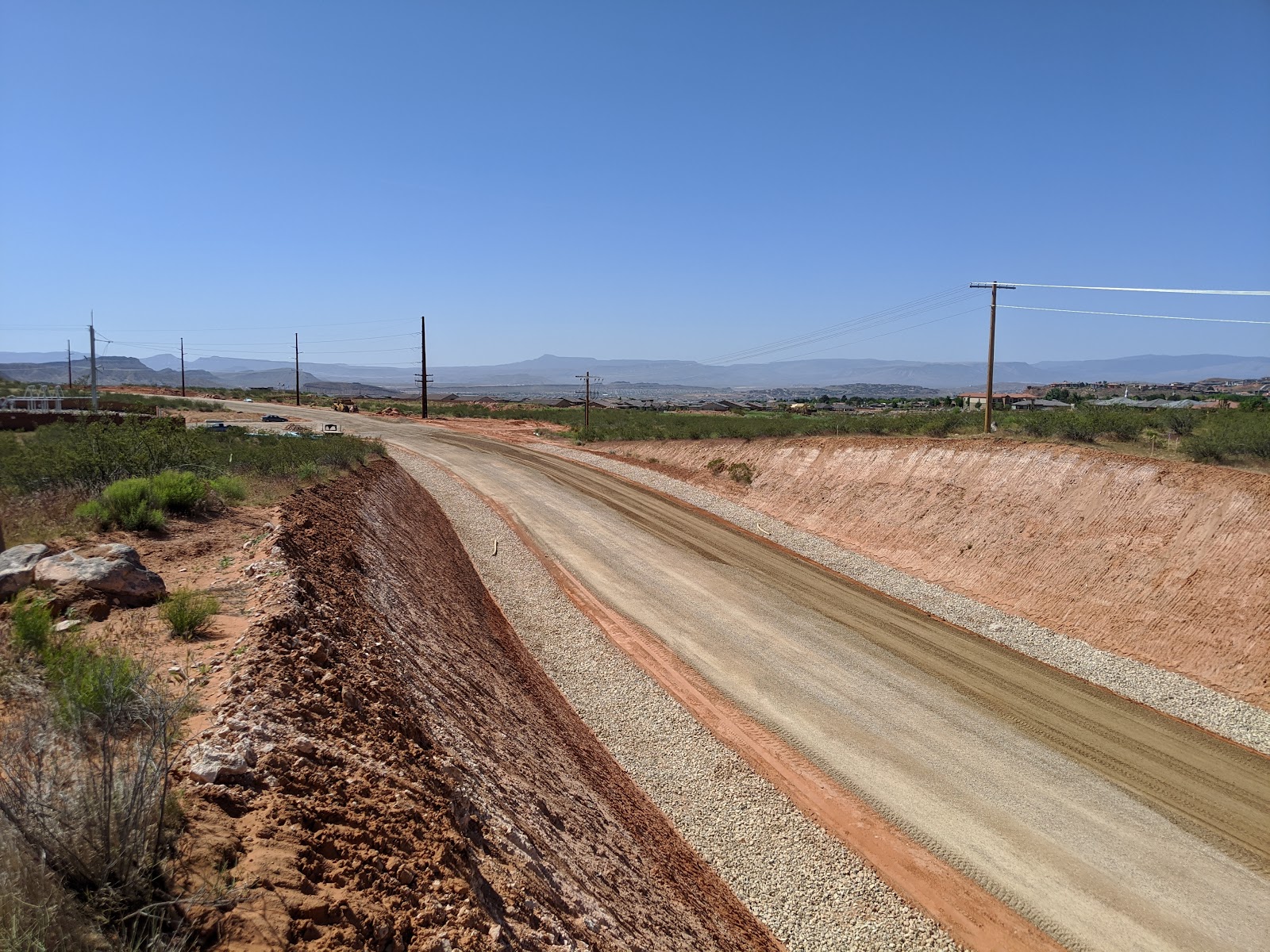

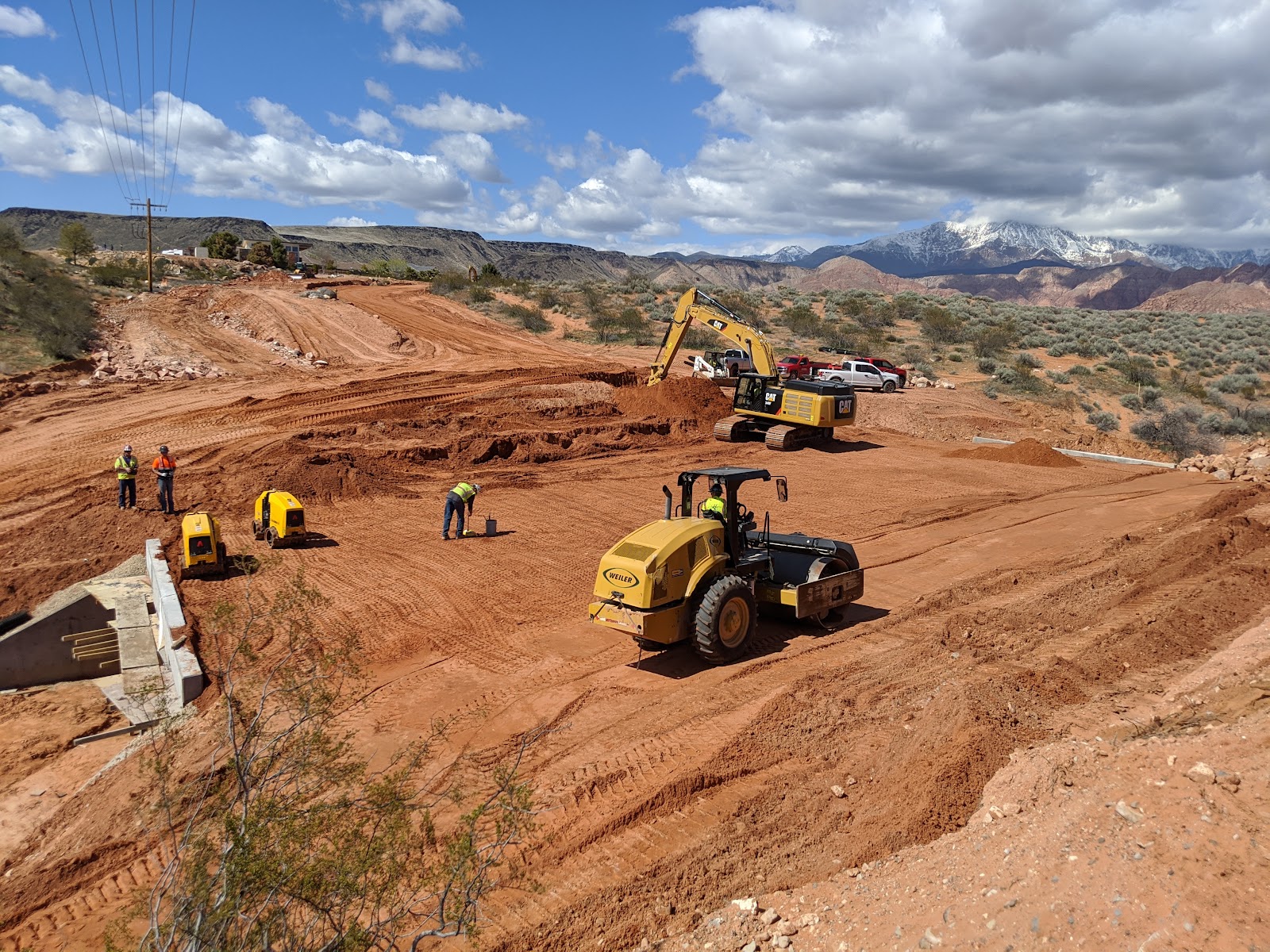

The Contractor is continuing work on replacing sections of waterline that run along the project. They have finished one run of waterline on the east end of the project and are finishing up another run along the west end of the project.  Starting at the east end of the project and working west, the Contractor has started the final grading of the subgrade and is installing riprap ditches that will run along the side of the road. The Contractor will continue preparing the rebar and forms for the top of the box structure and should be pouring the final concrete for the top of the box structure this week. Once the box structure crossing Mill Creek has been completed, the Contractor will start work on dirt grading, waterline installation, and storm drain pipe installation for the final section of the road crossing over the box structure.

Update 3/26/2020

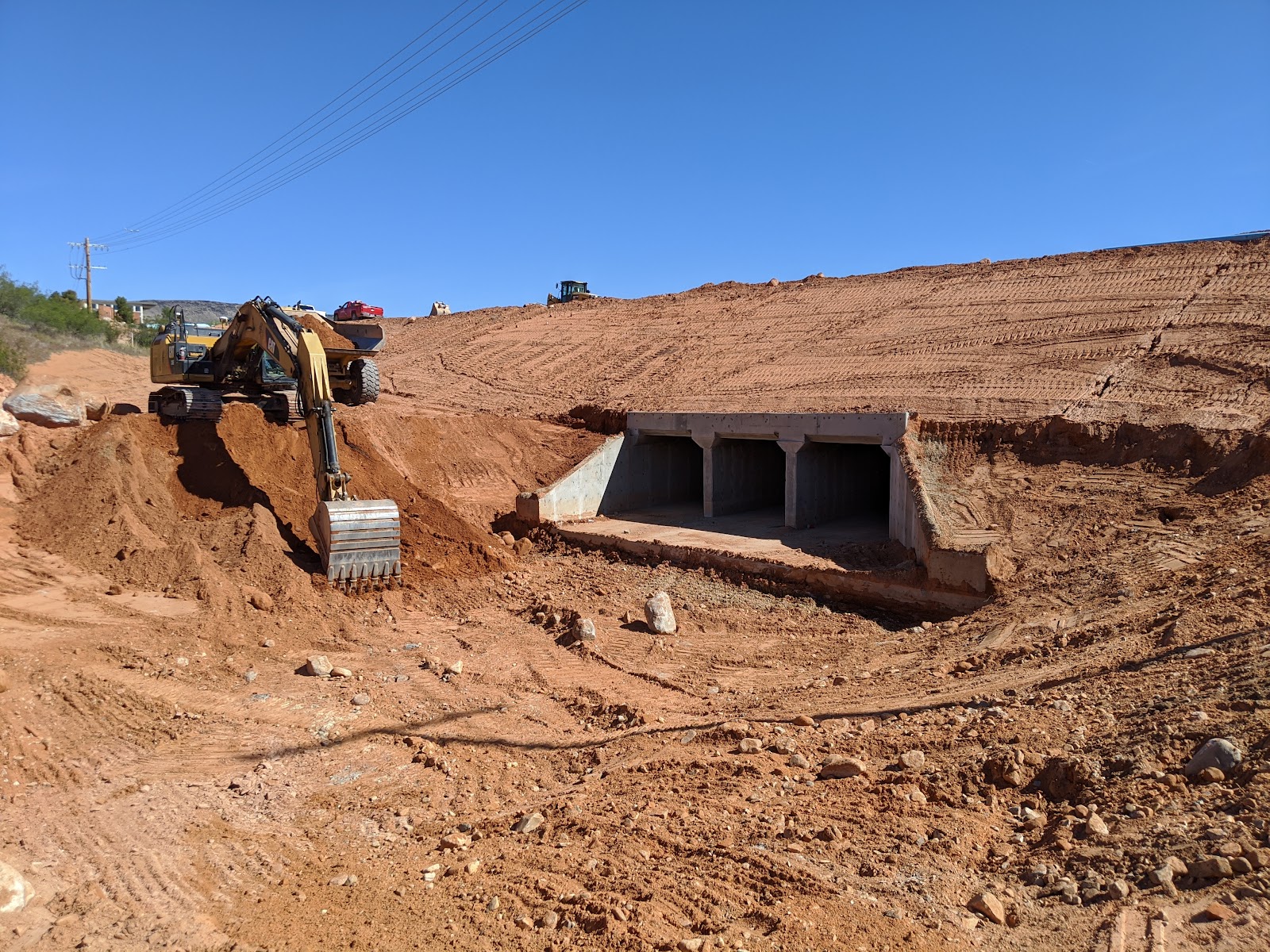

The Contractor is currently testing the new waterline completed on the west end of the project before they tie it into the rest of the water system. They are planning on connecting it in later this week. The Contractor is continuing their work on the final grading of the subgrade and installation of the gravel ditches that will run along the side of the road. They are working from the east to the west and have passed the halfway point. At the concrete box structure crossing the Mill Creek wash, the final concrete was poured nearly two weeks ago. The concrete will now just need to finish curing before the Contractor can start work on dirt grading, waterline installation, and storm drain pipe installation for the final section of the road crossing the box structure.

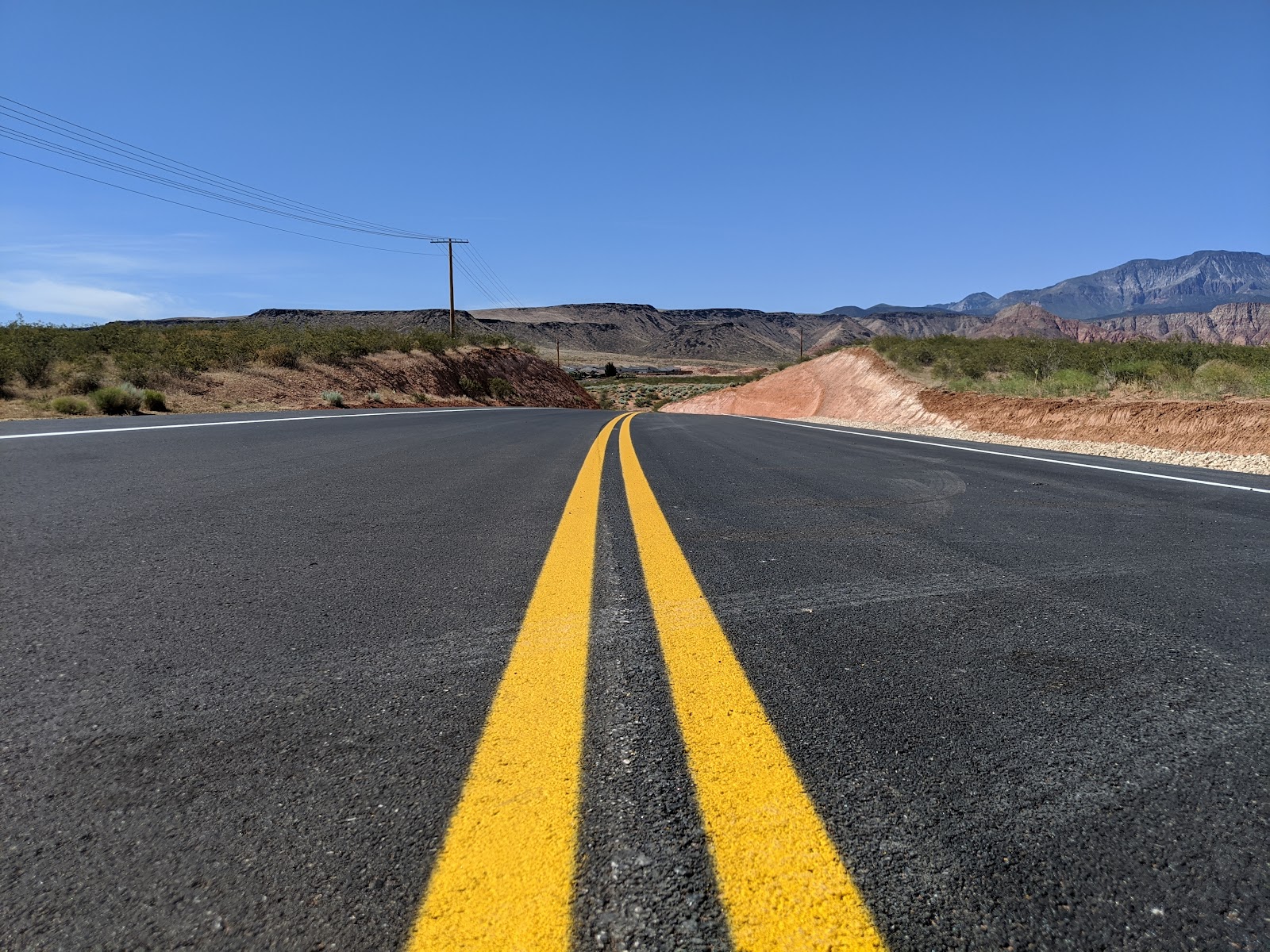

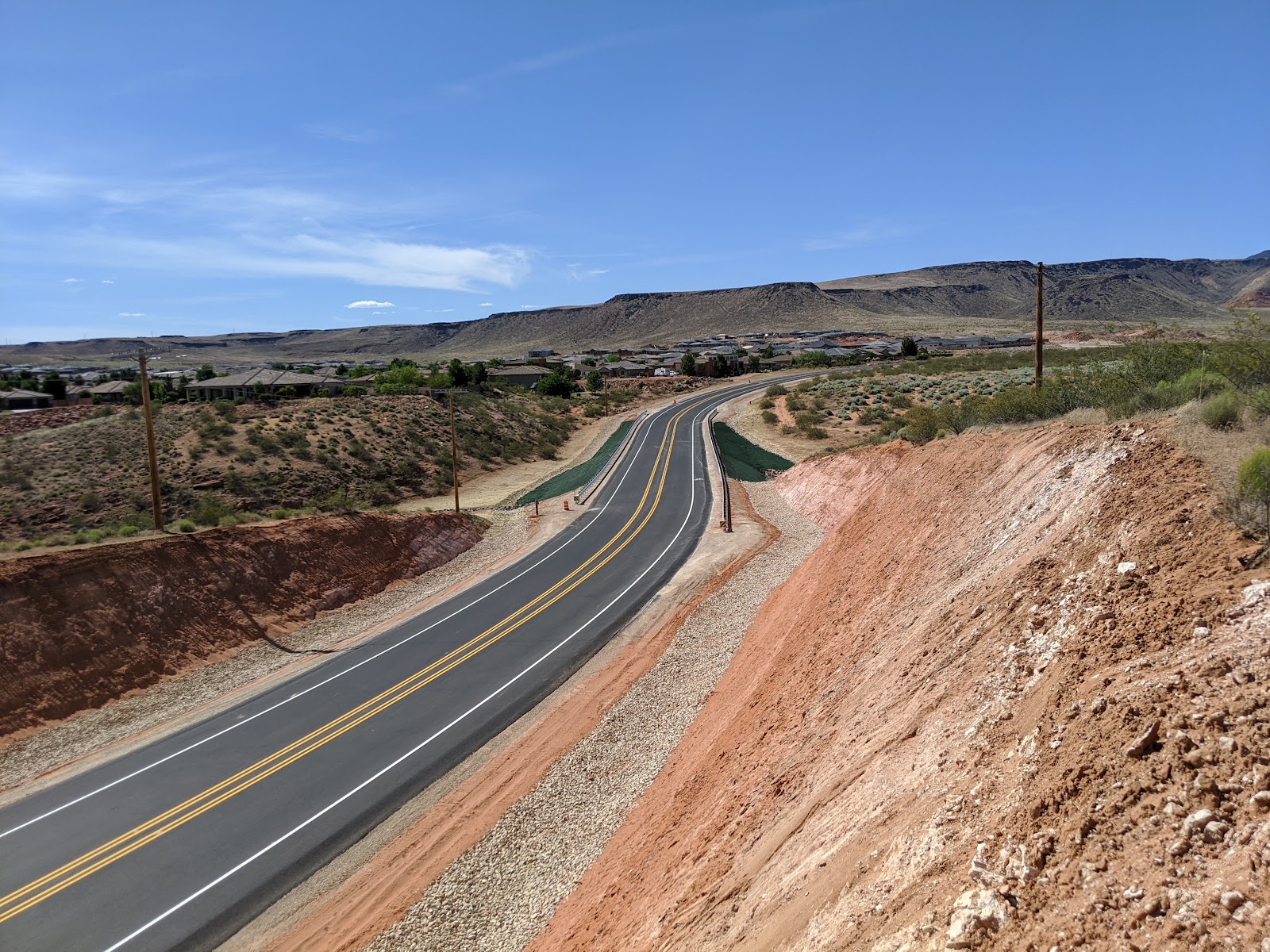

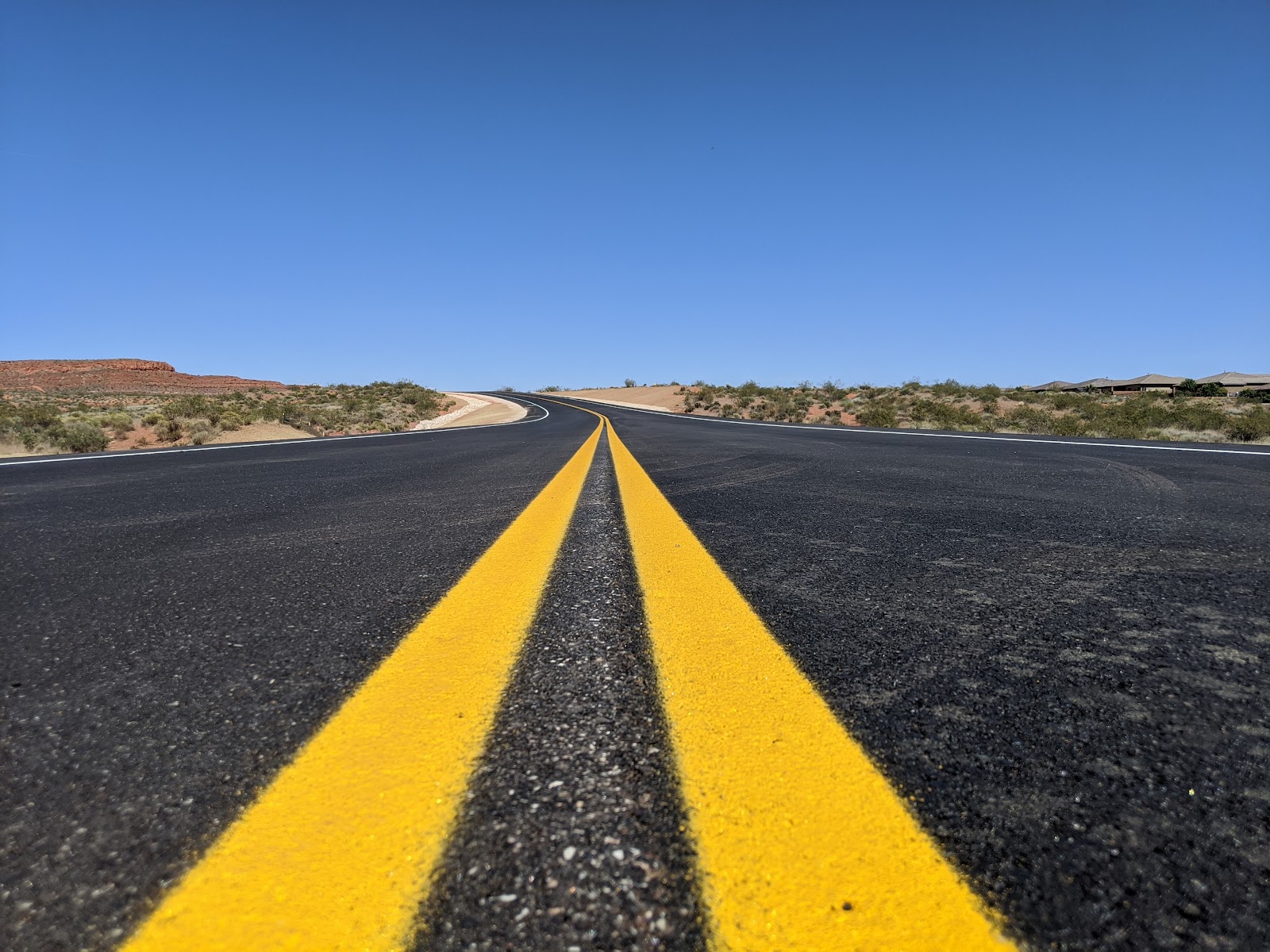

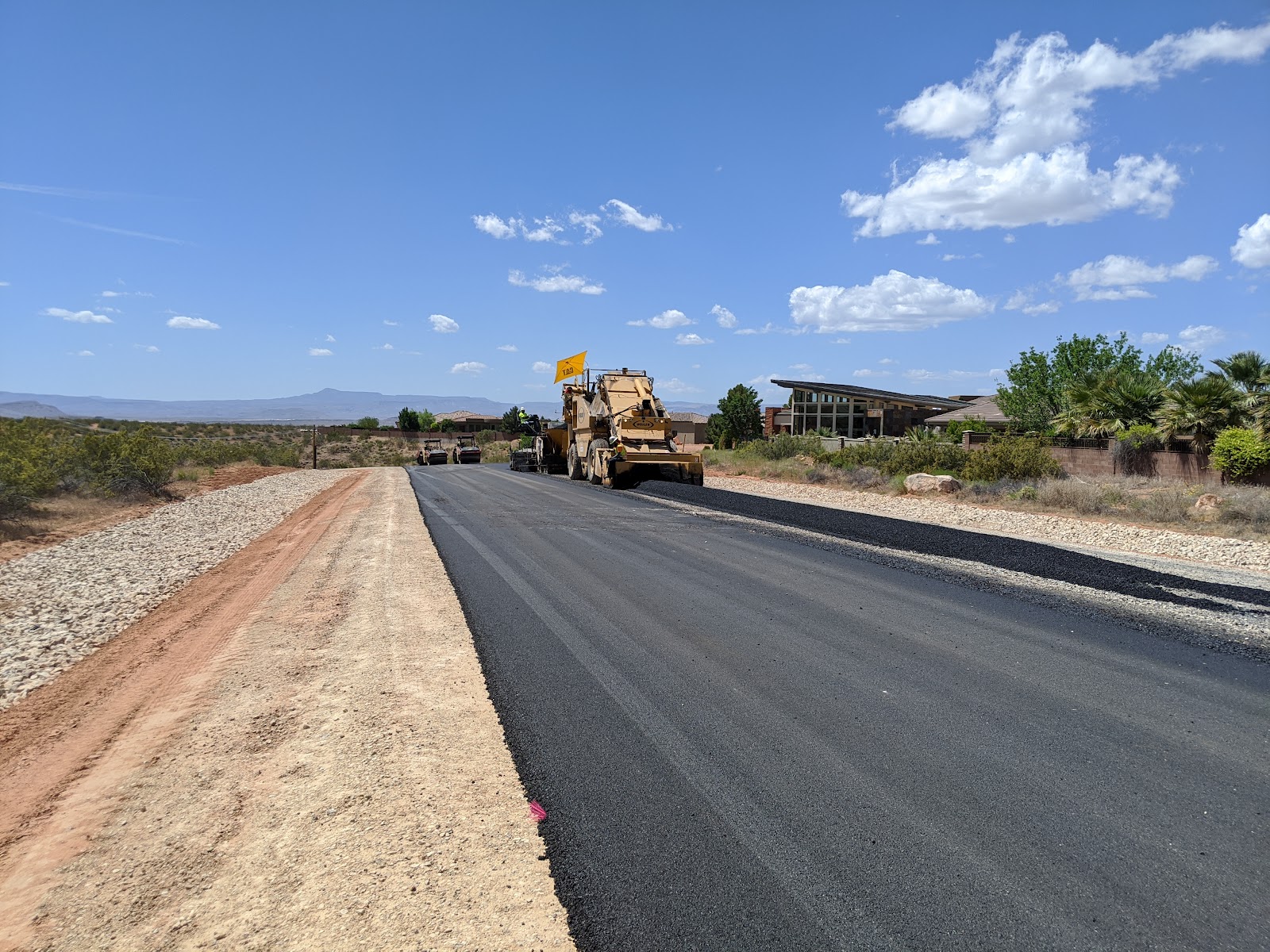

Schedule:

Construction start: January 2019

Construction completion: Substantial completion May 8 2020, contract time 125 working days


Project Information:

Boards 11x17.pdf - (pdf 8.64 MB)
Washington Parkway Saftey & Contractor Contact Information.pdf - (pdf 0.48 MB)



Return to Projects


Latest on Instagram:

Washington City Utah | (435) 656-6300
111 North 100 East | Washington, Utah 84780 [map]
© 2020 Washington City Corporation. All rights reserved.

Connect with Washington City:

Information on community COVID-19 response
